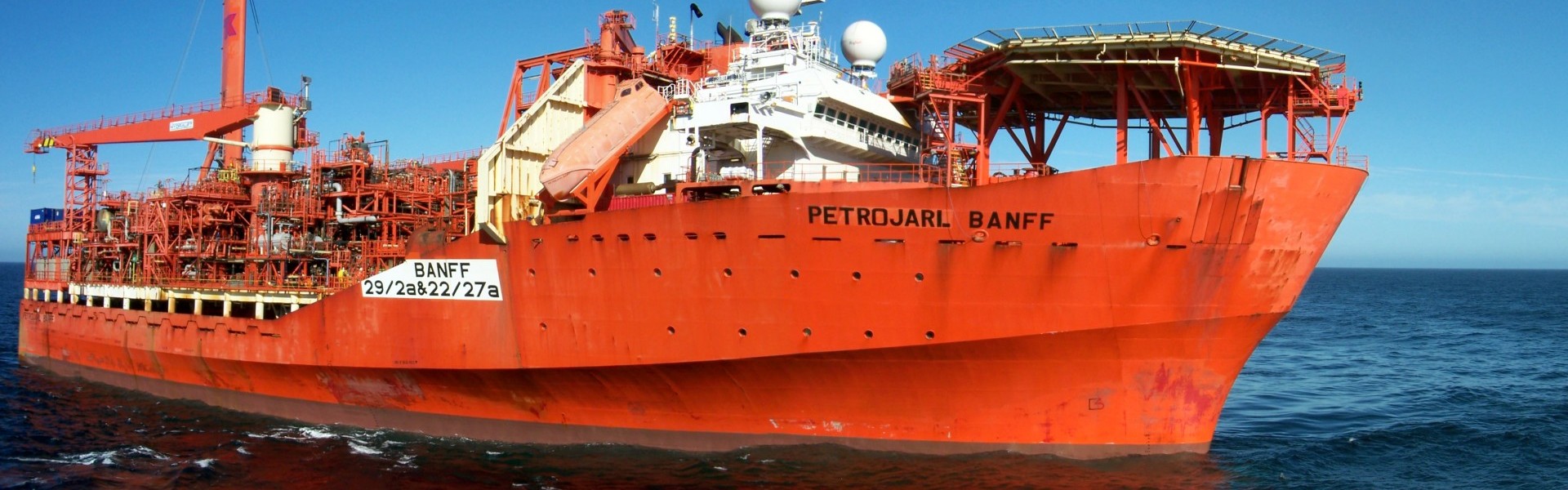

Petrojarl Banff; Source: Teekay

UK approves plan for removal of floaters from North Sea fields

UK authorities have approved the plan for the removal of the Petrojarl Banff FPSO and Apollo Spirit FSO from Canadian Natural Resources’ Banff and Kyle fields in the UK sector of the Central North Sea.

Petrojarl Banff; Source: Teekay

The Banff field is located in blocks 29/2a and 22/27a some 200 kilometres east of Aberdeen in approximately 95 meters of water.

The Kyle field is located in block 29/2c and 29/2h which are on the same distance from Aberdeen and in similar water depth.

There is one drill centre for the Banff and two drill centres for the Kyle field – North Kyle and South Kyle. The Banff wells and manifolds are located 1.6 kilometres southeast of the Petrojarl Banff FPSO while the Kyle wells and manifolds are located between 13 and 16 kilometres south of the FPSO.

The 120-meter long FPSO has been in production since 30 January 1999. It has a production capacity of 90,000 barrels a day.

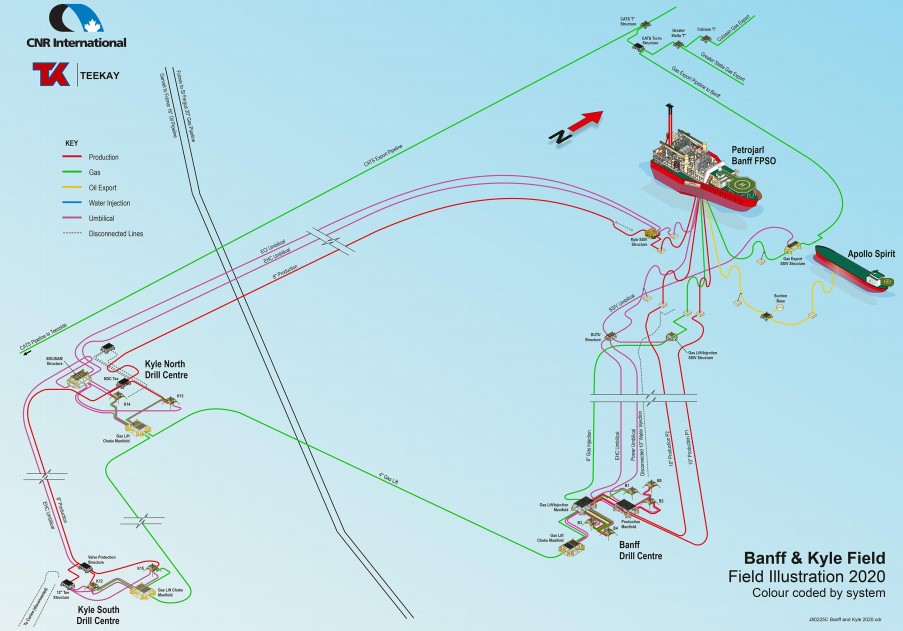

Source: CNR
Source: CNR

The accompanying Apollo Spirit is an FSO vessel, moored via a submerged turret loading (STL) system. The vessel receives processed oil from the Petrojarl Banff via a flexible riser. Oil is stored in the vessel’s cargo tanks and periodically offloaded to shuttle tankers. It has nine cargo tanks, with a total capacity of 910,000 bbl.

The previous oil export route for the FPSO was a submerged anchor loading system, which was removed during 2019.

Uneconomic alternatives

In the decommissioning plan, CNR stated that, as production rates from both fields decline, continued production from both fields would become uneconomical during 2020.

The field partners investigated various alternative production strategies to further extend the life of the fields, but no viable alternative to decommissioning has been identified.

Options considered to extend the life of the fields included near-field tie-back opportunities, de-bottlenecking of the Kyle field, and development drilling.

Since alternative production strategies were found to be uneconomic, cessation of production application was submitted to the UK Oil and Gas Authority (OGA), with approval granted in March 2020.

Decommissioning plan

The removal of the FPSO and FSO is part of a wider Banff and Kyle field decommissioning. This will be carried out in three distinct phases executed over five years.

The first phase covers the removal of the FPSO and FSO vessels from the field, while the second and third phases cover decommissioning of subsea installations and pipelines, and well plug and abandonment.

This approval only addresses Phase 1, which is currently planned for the summer of 2020 and will involve flushing and cleaning of the subsea production system and FPSO and FSO, implementation of required isolations, removal of the FPSO and FSO vessels from the field, as well as removal of buoyant flexible pipelines, and vessel mooring infrastructure.

Before FPSO and FSO removal, a risk-based assessment will be undertaken to determine suitable marking of the subsea infrastructure around the FPSO and FSO locations. Consideration will be given to providing a guard vessel or a cardinal buoy system to warn of the presence of subsea infrastructure.

It is worth noting that the remaining phases associated with the Banff and Kyle fields decommissioning will be covered by their own decommissioning programmes.

To remind, CNR decided to extend the charter for the Petrojarl Banff FPSO back in May 2019 and keep it working on the fields until the end of August 2020.
